How Much Does a Seawater Desalination Plant Cost?
A useful seawater desalination budget starts with the supply scope. In six selected GlobalUF equipment quotations and budget proposals from 2026, systems ranging from 24 to approximately 1,000 m³/day had equipment line items of US$24,000 to US$644,000. These are historical, project-specific examples—not a standard price list or the total cost of building an operating plant.
All equipment prices in this article are indicative historical references. Final quotations depend on the selected component brands and models, whether an energy recovery device (ERD) is included, feedwater and product-water requirements, and the agreed supply and service scope. A system with the same nominal capacity can therefore have a materially different price.
Divide the relevant investment by the plant’s daily product-water capacity to calculate US$ per m³/day of capacity. This tells a buyer how much capital is associated with a unit of production capacity. It does not tell the buyer the cost of producing one cubic metre of water.
For an island, resort, coastal community or industrial facility, the practical question is: what must be added to the equipment quotation before the project can supply usable water?

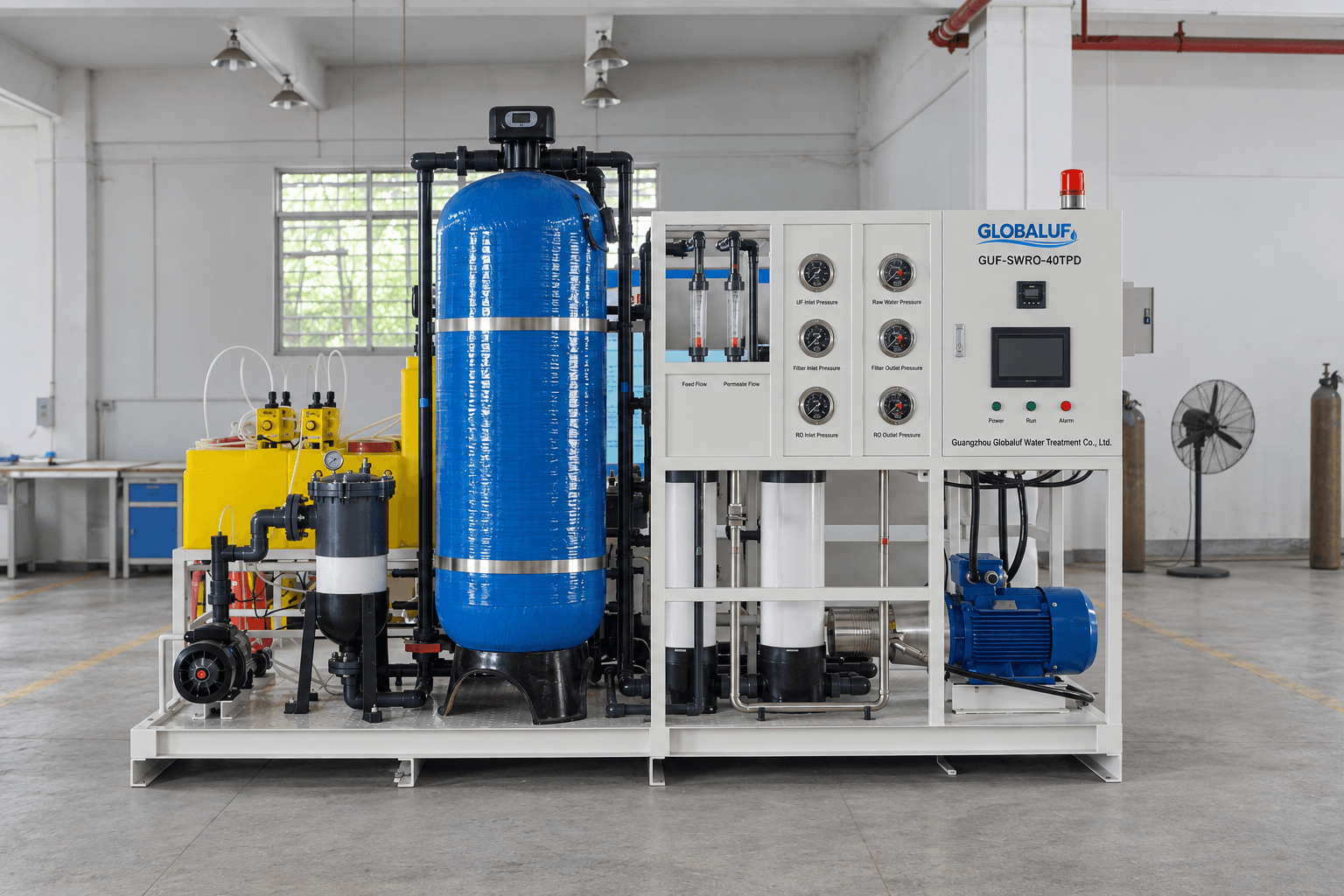

GlobalUF GUF-SWRO-40TPD equipment shown for configuration illustration. This photograph does not establish the supply scope or price of any quotation in the comparison.
What do small and medium SWRO equipment quotations show?
The selected examples below cover seawater reverse osmosis (SWRO) equipment. Prices are in their original quoted US dollars. Customer identities have been removed. The figures describe proposed supply, not completed projects or measured operating results.
| Quotation period | Product-water capacity | Equipment line item | Equipment cost per m³/day of capacity | Scope note |
|---|---|---|---|---|
| October 2026 | 24 m³/day | US$24,000 | US$1,000 | 1 m³/h skid; solar, consumables and freight quoted separately; final delivery terms pending |
| May 2026 | 40 m³/day | US$40,800 | US$1,020 | SWRO equipment line; a separate US$5,500 logistics/container-related line requires scope clarification |
| August 2026 | 100 m³/day | US$80,000 | US$800 | Containerized equipment budget; freight and overseas commissioning additional |
| June 2026 | 150 m³/day | US$165,000 | US$1,100 | Containerized system; spare parts and CIF freight/insurance additional |
| April 2026 | 480 m³/day equivalent* | US$265,000 | US$552 | Revised 20 m³/h containerized SWRO equipment line; spares, site support and freight separate |
| October 2026 | 1,008 m³/day | US$644,000 | US$639 | 42 m³/h × 24 hours/day, nominally described as a 1,000 m³/day project; FOB China equipment budget |
The 480 m³/day figure is a comparison assumption: 20 m³/h operating for 24 hours. It is not a confirmed operating schedule or guaranteed daily net production. The 24 m³/day example has a requested 24-hour schedule. All actual production remains dependent on the agreed design conditions and availability.
These six examples were selected because an equipment price could be identified separately. They are not a representative market survey. Equipment configurations and delivery boundaries differ, so the table should not be used to interpolate a price for another capacity. The 150 m³/day example, for instance, has a higher ratio than the 100 m³/day example. Capacity alone does not explain price.
How should investment per unit of capacity be calculated?
For smaller projects, see GlobalUF’s skid-mounted SWRO systems for 10–150 m³/day for configuration considerations. Projects needing an enclosed equipment package can explore containerized seawater reverse osmosis systems. These product pages describe available configurations; the quotation must identify what is included for the specific project.
Use the quoted product-water capacity and the matching cost boundary:
Specific equipment investment = equipment price in US$ ÷ product-water capacity in m³/day
For the 100 m³/day example:
US$80,000 ÷ 100 m³/day = US$800 per m³/day of capacity.
Adding its separate US$1,500 freight allowance and US$5,000 commissioning allowance gives US$86,500, or US$865 per m³/day. That expanded figure still excludes the intake, tanks, civil works and other site items identified in the proposal.
For a system quoted in m³/h, calculate daily capacity as hourly product flow multiplied by the assumed operating hours. State those hours beside the result. A standby train should not automatically be counted as additional daily production.
Use m³/day in the published comparison rather than an undefined “tonne of water.” This keeps the capacity basis clear and avoids confusing feedwater mass, product-water volume and actual annual output.
Why can two SWRO systems with the same capacity have different prices?
Compare the equipment specification and supply boundary before comparing the total. Three questions are particularly useful:
| Cost driver | What to compare in the quotation |
|---|---|
| Component brands and models | Membrane model and quantity; pump duty and wetted materials; instruments; dosing pumps; PLC, HMI and drives; warranty and service provisions |
| Energy recovery device (ERD) | Whether an ERD is included; its type and model; compatible pump arrangement; predicted electrical consumption at the same feedwater conditions and net product-water duty |
| Supply and service scope | Pretreatment, CIP, post-treatment, enclosure, tanks, intake/outfall, freight, installation, commissioning and spares |
A brand name alone does not define equivalent equipment. Buyers should compare model, material, duty, acceptance requirements and local service availability. GlobalUF’s water treatment components and consumables page provides an overview of component categories; the project quotation establishes the selected items and prices.
An ERD recovers pressure energy from the concentrate stream and can reduce purchased electricity consumption. Including one changes the equipment configuration and investment. Its economic value depends on the actual energy saving, electricity tariff, annual operating hours and additional maintenance costs. A fixed energy-saving percentage or payback period should not be assumed.
In the reviewed three-capacity proposal, the preliminary 10 and 25 m³/h equipment lists explicitly include energy recovery units. The 1 m³/h list does not identify an ERD; that omission still requires confirmation in the final equipment schedule. These differences prevent a capacity-only price comparison.
For a meaningful with-ERD versus without-ERD comparison, request two technically comparable proposals using the same feedwater, product-water target, operating schedule and supply boundary. Compare both installed investment and annual operating expenditure.
What can be missing from a desalination equipment price?
A buyer’s installed-project budget can contain costs that are outside the supplier’s equipment package. Check each item explicitly rather than applying a universal installation percentage.
| Budget item | What to establish |
|---|---|
| Seawater intake and pretreatment | Intake type, seasonal water quality, pumping and pretreatment responsibility |
| SWRO equipment | Membranes, high-pressure pump, energy recovery where specified, instruments, controls and cleaning equipment |
| Final water treatment | Required product-water quality, boron assessment where relevant, remineralization and disinfection scope |
| Site works | Foundations, buildings or container placement, tanks, external piping, cabling and access |
| Concentrate management | Discharge route, site engineering, environmental assessment and permits |
| Delivery and startup | Packing, freight, insurance, destination handling, duties, installation and commissioning |
| Operating readiness | Initial chemicals, spare parts, operator training and agreed documentation |
A containerized system still needs site connections and a defined startup responsibility. Similarly, a CIF quotation does not by itself establish that local installation, taxes or a complete intake and outfall system are included.

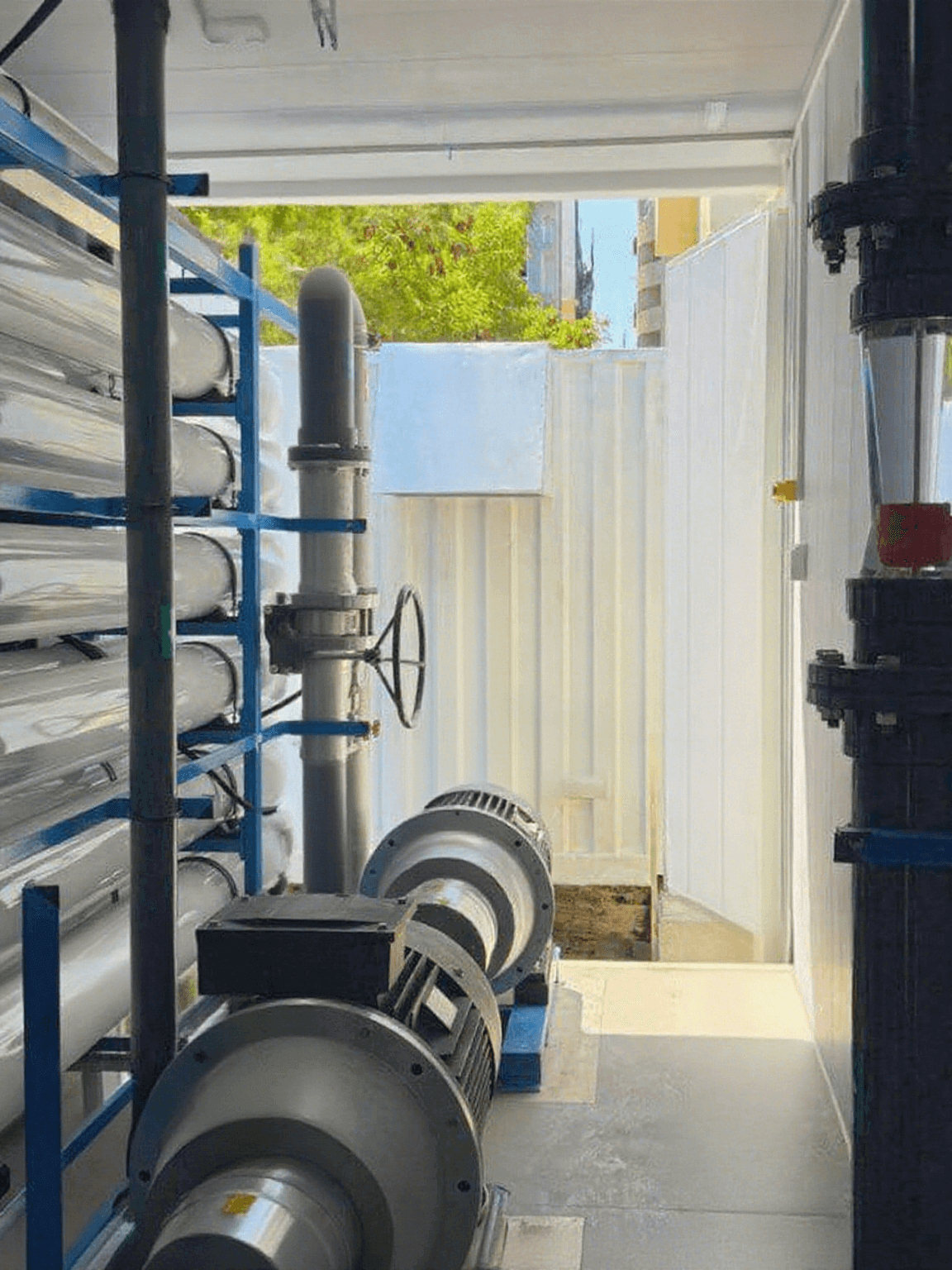

Interior equipment arrangement in a containerized SWRO system. Intake, external piping, electrical connections and site works must be checked separately in the project budget.
How do solar-powered and marine systems affect the comparison?
Solar and marine packages need separate comparisons because their prices may cover different equipment and performance requirements.
One 2026 preliminary proposal offered SWRO plus grid-connected solar packages at US$36,377 for 1 m³/h, US$203,436 for 10 m³/h and US$317,044 for 25 m³/h. At an assumed 24 operating hours per day, those package ratios are approximately US$1,516, US$848 and US$528 per m³/day respectively.
Those figures include the proposed solar packages and cannot be treated as SWRO-only equipment prices. They are three alternatives within one project inquiry, not three independent project observations. The proposal excludes batteries and relies on utility power outside, or in addition to, solar contribution. Actual operating hours still require confirmation.
Marine examples should also remain separate. A three-unit 50 m³/day procurement had an equipment line of US$40,000 per unit. A different 50 m³/day double-pass marine proposal was US$51,500 on a CIF basis. The second figure includes a different process and commercial boundary; dividing both by 50 does not make them equivalent offers.
What do large desalination plants cost?
Large public projects provide useful context, but their disclosed project costs are a different category from equipment-only quotations.
The following calculations use the developer’s project-cost and capacity fields accessed on 20 October 2026. Figures are nominal disclosed US-dollar amounts, not costs adjusted to a common construction year.
These public disclosures provide identifiable, traceable reference points for named projects. They are stronger evidence for the amounts reported by the developer than an unattributed market estimate. However, a published “project cost” should not automatically be described as an audited final construction cost: it may represent the disclosed investment at a particular project stage. Publication date, scope and subsequent revisions still matter.
| Public project | Published capacity | Published project cost | Calculated US$ per m³/day |
|---|---|---|---|
| Taweelah IWP | 909,201 m³/day | US$907 million | US$998 |
| Umm Al Quwain IWP | 681,900 m³/day | US$797 million | US$1,169 |
| Rabigh 3 IWP | 600,000 m³/day | US$666 million | US$1,110 |
| Jubail 3A / Jazlah IWP | 600,000 m³/day | US$658 million | US$1,097 |
These are developer-reported project costs; the public summaries do not provide a fully harmonized line-by-line cost boundary. They should not be pooled with the small-system equipment examples to calculate an industry average.
A similar-looking ratio does not mean a small equipment package and a municipal desalination project provide the same scope. Nor does it establish which supplier is cheaper. Procurement terms, project year, infrastructure, location and operating requirements need to be aligned first.
Is investment per m³/day the same as water cost per m³?
No. Investment per m³/day measures capital against daily production capacity. Water cost per m³ measures expenditure against water actually produced.
A simplified annual calculation is:
Water cost per m³ = (annualized installed capital cost + annual operating cost) ÷ annual net usable water production
The calculation needs a stated capital-recovery method, project life, operating hours, availability, electricity price, chemical and maintenance costs, staffing, replacements and usable-water output. A purchase price and nameplate capacity are insufficient.
The reviewed quotations do not provide a consistent complete dataset for that calculation. They therefore support a capital-budget comparison, not a universal claim that seawater can be produced at a particular US$/m³.
How can chemicals, cartridges and electricity be budgeted?

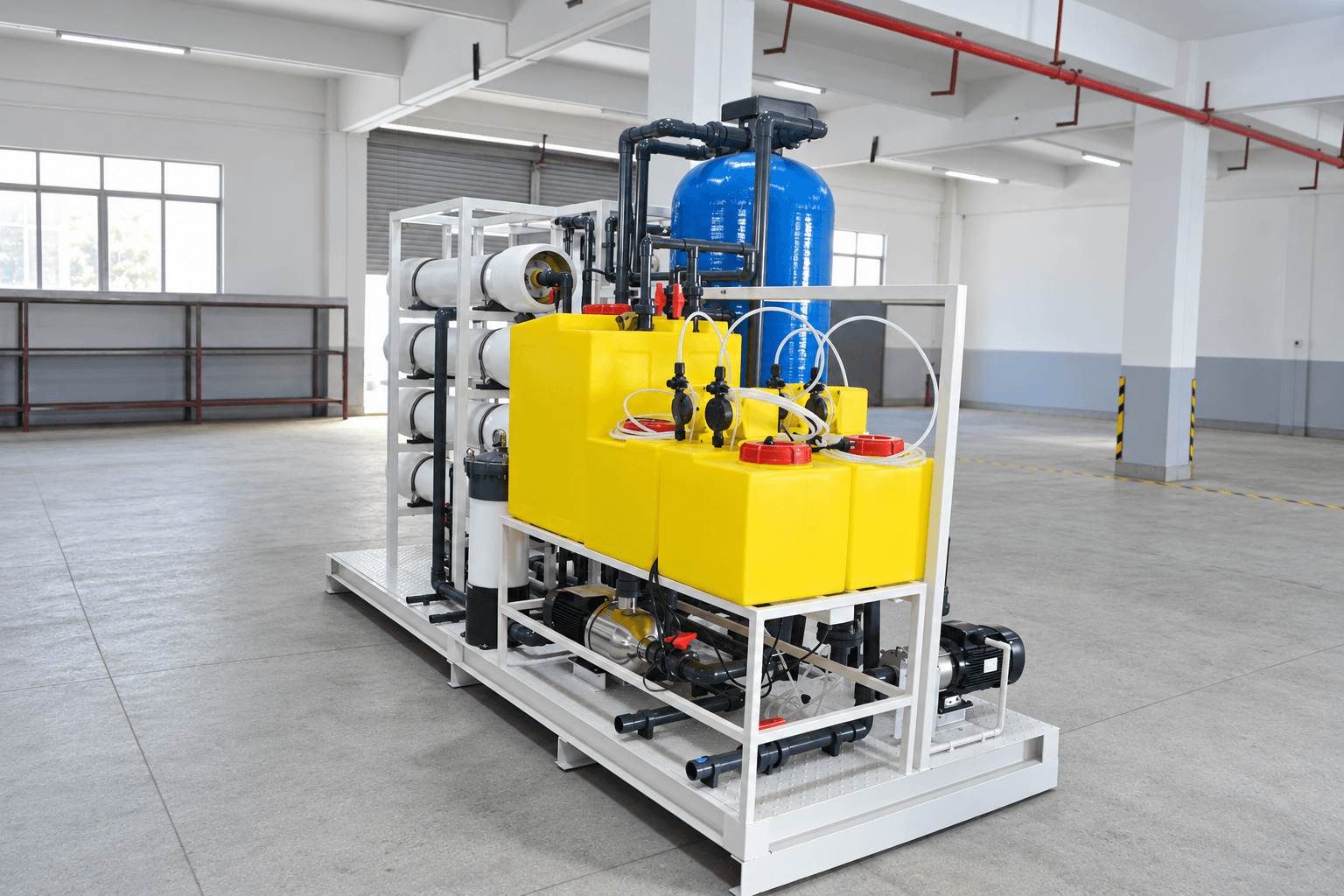

Chemical dosing and pretreatment equipment on a GlobalUF SWRO skid. This is an equipment illustration, not a photograph of the proposed Mexico installation or evidence of its annual chemical consumption.
An October 2026 GlobalUF budget schedule provides preliminary annual chemical and cartridge allowances for three proposed SWRO capacities. These are quoted allowances, not measured consumption or confirmed local procurement costs.
The following division assumes 24 operating hours per day, 360 days per year and all nominal product water available for use. The schedule uses 360 days, but daily operating hours and actual net delivered output remain unconfirmed.
| Proposed capacity | Cartridge allowance, US$/year | Chemical allowance including CIP, US$/year | Quoted total, US$/year | Conditional chemical + cartridge allowance, US$/m³ |
|---|---|---|---|---|
| 1 m³/h | 776.11 | 650.30 | 1,426.42 | 0.165 |
| 10 m³/h | 5,480.60 | 2,464.18 | 7,944.78 | 0.092 |
| 25 m³/h | 13,701.50 | 6,152.97 | 19,854.48 | 0.092 |
The quoted totals for the 1 and 25 m³/h options exceed the sum of displayed line amounts by US$0.01 because of source rounding. The original quoted totals are retained.
These figures need technical reconciliation before becoming a project operating-cost estimate. Cartridge specifications and service positions are not fully consistent with the preliminary equipment list. Annual chemical quantities have not been reconciled with dosing-point flows, commercial concentrations and operating hours. Reducing operating hours changes both output and potentially consumption; simply retaining the same annual budget and dividing by less water is only a fixed-budget allocation scenario.
Electricity should be calculated separately:
Electricity cost per net m³ = electricity consumed per net m³ × electricity price per kWh.
For a purely illustrative calculation, 4 kWh/m³ at US$0.15/kWh gives US$0.60/m³ for electricity. Adding the conditional allowances above gives approximately US$0.765, US$0.692 and US$0.692/m³ for electricity, listed chemicals and cartridges. Neither 4 kWh/m³ nor US$0.15/kWh is a verified input for these proposals or a performance prediction. Using the same hypothetical energy input for all three options does not establish equal actual energy performance.
This subtotal excludes membrane replacement, filter media, other spares, labor, maintenance, testing and any additional site or waste-handling costs. It also excludes capital recovery, financing and tariff demand/fixed charges. It must not be described as total desalinated-water cost.
Solar inverter capacity is not the SWRO plant’s electrical consumption. The proposed grid-connected solar packages do not establish a verified electricity saving. A solar-adjusted budget needs actual usable PV generation, load timing and the applicable tariff, as well as PV maintenance and capital costs.
What information is needed for a useful SWRO budget?
Start with the seawater analysis, required daily product-water output and intended use. Then define operating hours, power supply, site location, installation arrangement and delivery boundary.
Use the RO system quotation checklist to prepare those inputs. When requesting a GlobalUF proposal, ask for equipment, optional solar, spare parts, freight and site services as separate lines. That makes it easier to compare offers and identify the remaining project budget.
Send your water analysis and project requirements for a project-specific SWRO equipment budget. Final design and pricing depend on the complete feedwater analysis and the agreed supply scope.
Request a Quote
Fill out the form below to discuss your water treatment needs. Our experts will get back to you within 24 hours.
You may also be interested in:
5 Notable BWRO Desalination Projects and Their Design Lessons

How to Choose a Containerized RO System for Islands and Remote Sites

Exploring the Top 5 SWRO Desalination Plants in the World(2025)

How to Choose Brackish RO Membrane for Your Desalination Plant
